Just ordered my 392!

Alleycat392

Well-Known Member
First Name
Alex
Joined
Sep 17, 2018
Threads
8
Messages
420
Reaction score
629
Location
Hewlett, NY
Vehicle(s)
2008 Jeep Wrangler Unlimited Metal Mulisha Custom
I have been in a “D” status awaiting scheduling and parts for build since December 10th.


Sponsored

Hogpup

Well-Known Member
First Name
Danny
Joined
Feb 17, 2018
Threads
12
Messages
117
Reaction score
140
Location
Guilford IN.
Vehicle(s)
JKU Rubicon
If you are in D status you would have a VIN# and be scheduled for build, there are no 392 scheduled for build yet. That won't happen till they release pricing.
Scheduled:
C = tentative schedule
D = firm schedule: serial number assigned
D1 = gateline: unit sequenced for production, est ship date assigned


weeitsmikelee

Well-Known Member
First Name
Michael
Joined
Feb 26, 2018
Threads
70
Messages
1,306
Reaction score
1,302
Location
Durrty Jersey
Vehicle(s)
‘21 Wrangler392; ‘20 F-Pace; '15 XL883N; '82 CX500
Occupation
Healthcare
Vehicle Showcase
2
If you are in D status you would have a VIN# and be scheduled for build, there are no 392 scheduled for build yet. That won't happen till they release pricing.
Scheduled:
C = tentative schedule
D = firm schedule: serial number assigned
D1 = gateline: unit sequenced for production, est ship date assigned

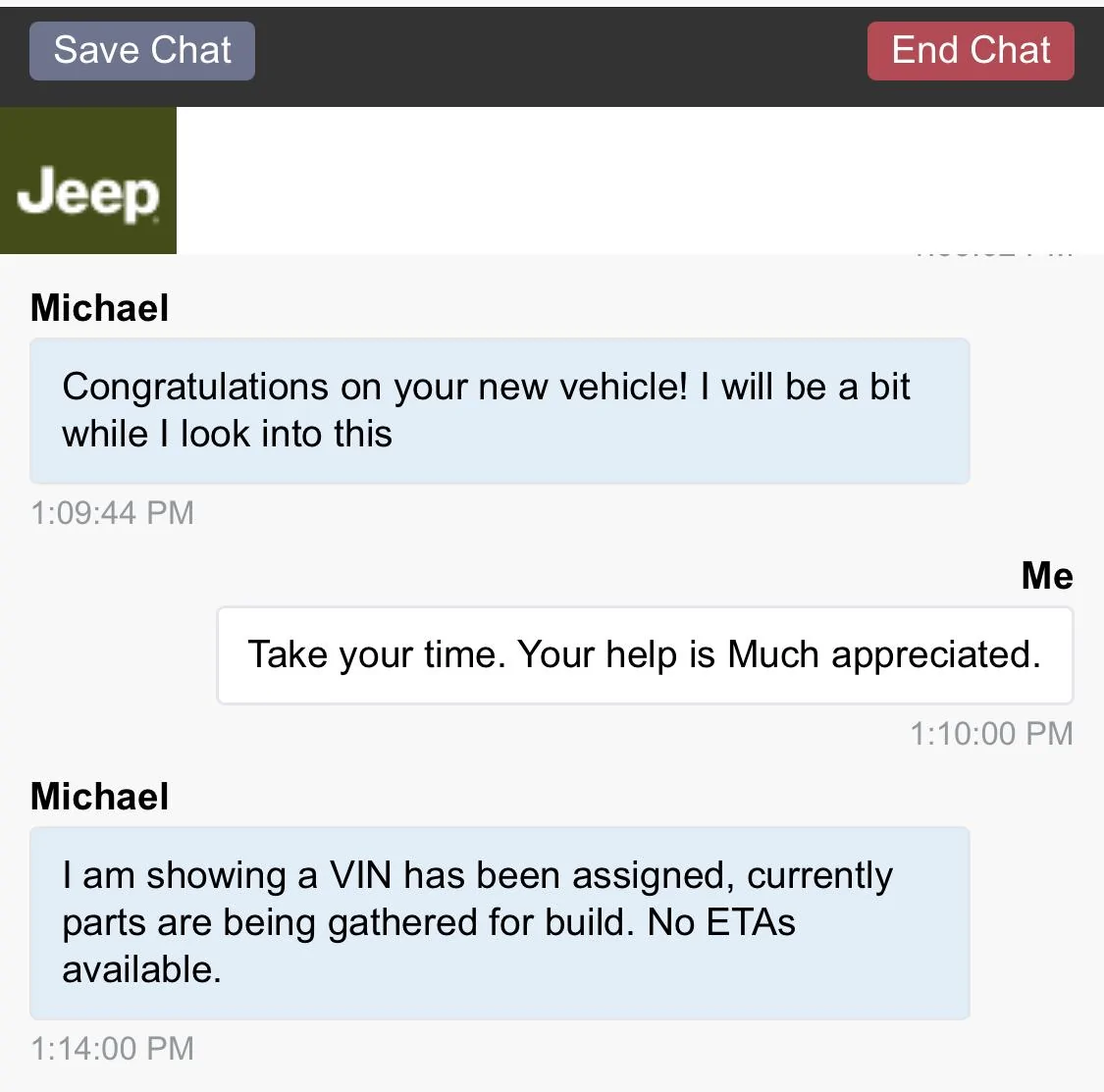

Ah sorry. The Jeep chat rep said I was awaiting parts to build. No VIN yet. Thought that was “D” status. Good to know


Hogpup

Well-Known Member
First Name
Danny
Joined
Feb 17, 2018
Threads
12
Messages
117
Reaction score
140
Location
Guilford IN.
Vehicle(s)
JKU Rubicon
Here's the list so everyone can truly know what your order status code means.
Unscheduled:
BX = good order available for scheduling
BB = fleet order only ñ review by bid department
BD = special equipment processing
BE = edit error - coding error which must be corrected before order can be scheduled
BG = order has passes edit but cannot be scheduled regardless of sold status

Reason Codes:
F = finance hold - automatic cancellation after 15 days
B = model or option build out
L = material restriction
M = material hold (fleet)
ZA = canceled order

Scheduled:
C = tentative schedule
D = firm schedule: serial number assigned
D1 = gateline: unit sequenced for production, est ship date assigned

Build:
E = framing
F = paint
G = trim

Built:
I = unit built, pending final inspection
J = vehicle passed final inspection but not released to carrier
JB = shipped to body vendor
JE = shipped to emissions
JJ = consigned to body vendor
JS = shipped to storage
KZ = released by plant and invoiced

Traffic Codes:
KZ L = released but not shipped
KZ M = first rail departure
KZ N = first rail arrival
KZ O = delayed/received
KZ OA = plant hold, quality audit
KZ OB = zone, dealer, sales, vehicle prep, tax, diversion or derailment hold, dealer refusal, vehicle diverted
KZ OC = carrier delay, strike-bound, emission or safety hold, rail car shortage, bad or insufficient load, inclement weather, need shipping order, manifest error
KZ OD = mechanical failure, glass damage, vehicle in repair, lacking parts or storage hold
KZ OE = misdropped or misshipped vehicle
KZ OF = shipped air freight, stolen vehicle recovered, show vehicle, test info code, vessel sailed
KZ OG = damaged vehicle, stolen vehicle, abandon to carrier, vehicle scrapped, donate vehicle, repair and auction
KZ OH = all other type carrier codes
kZ R = vehicle within a few days of dealer
KZ T = second rail departure
KZ U = second rail arrival
KZ X = delivered to dealer
KZ Y1 = major damage ñ must not be sold as new
KZ Y2 = major damage ñ vehicle sold at auction


Sponsored

Alleycat392

Well-Known Member
First Name
Alex
Joined
Sep 17, 2018
Threads
8
Messages
420
Reaction score
629
Location
Hewlett, NY
Vehicle(s)
2008 Jeep Wrangler Unlimited Metal Mulisha Custom
If you are in D status you would have a VIN# and be scheduled for build, there are no 392 scheduled for build yet. That won't happen till they release pricing.
Scheduled:
C = tentative schedule
D = firm schedule: serial number assigned
D1 = gateline: unit sequenced for production, est ship date assigned

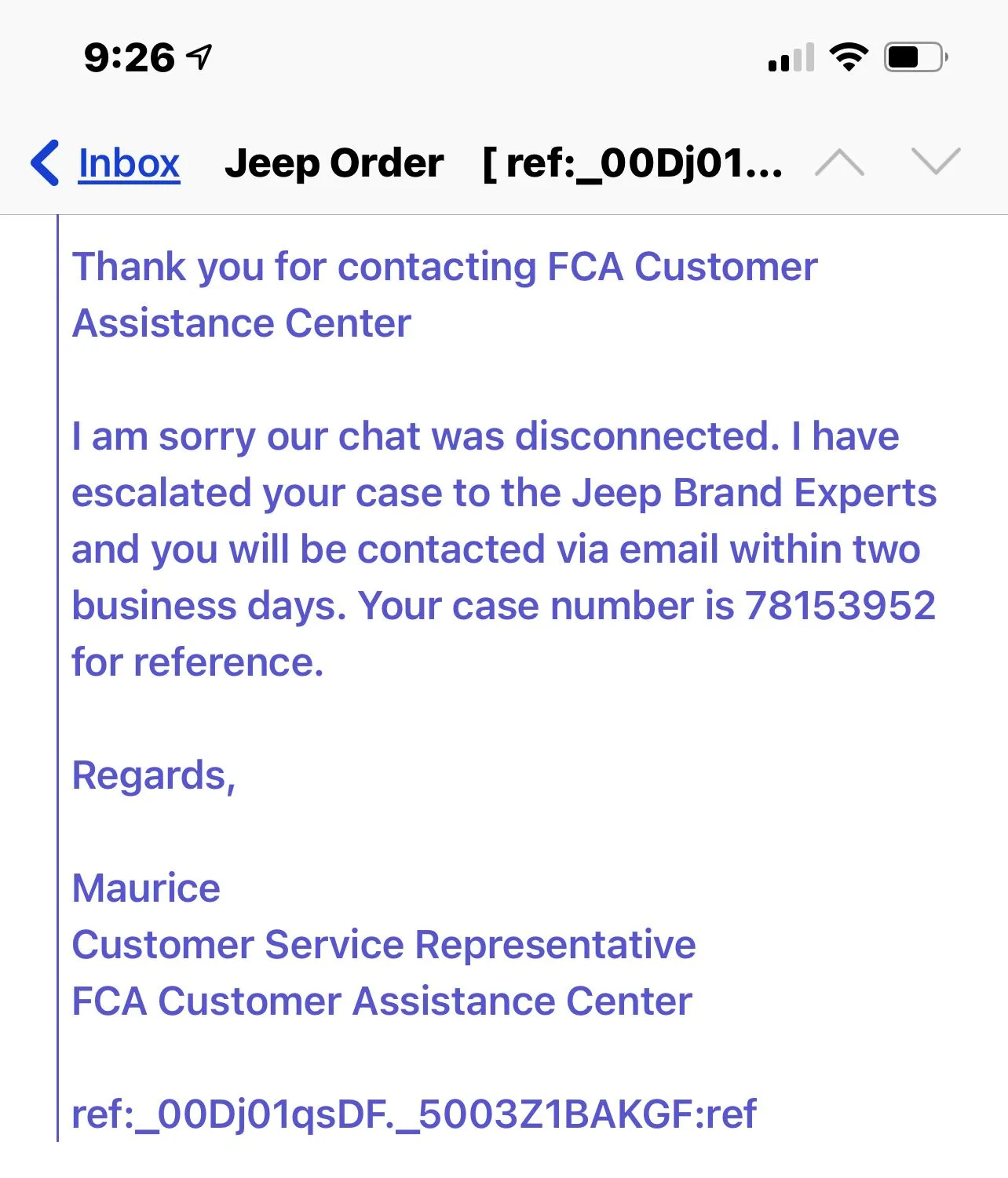

I have a VIN #. Have had one since December 10th. Have been told by Jeep Care on multiple occasions that I am 100% in D status, yet no estimated build date yet. Last convo with them was Friday and they escalated case. They also told me that since as of Monday I will have had a VIN for over 30 days, I should expect a change in status.


Hogpup

Well-Known Member
First Name
Danny
Joined
Feb 17, 2018
Threads
12
Messages
117
Reaction score
140
Location
Guilford IN.
Vehicle(s)
JKU Rubicon
I have a VIN #. Have had one since December 10th. Have been told by Jeep Care on multiple occasions that I am 100% in D status, yet no estimated build date yet. Last convo with them was Friday and they escalated case. They also told me that since as of Monday I will have had a VIN for over 30 days, I should expect a change in status.
Keep us posted,
I have a VIN #. Have had one since December 10th. Have been told by Jeep Care on multiple occasions that I am 100% in D status, yet no estimated build date yet. Last convo with them was Friday and they escalated case. They also told me that since as of Monday I will have had a VIN for over 30 days, I should expect a change in status.
There should be a Letter on the 8th position of the VIN what is it.


TCS1666

Well-Known Member
First Name
Ted
Joined
Dec 15, 2017
Threads
2
Messages
135
Reaction score
255
Location
Indianapolis
Vehicle(s)
2010 GMC Sierra Denali - 2021 Jeep Wrangler Rubicon 392 (ordered) - 2017 GMC Acadia Denali (sold)
In the same boat as @ALLEYCAT740 , VIN has been assigned since 12/10 and in D status. Come onD1...
